The 2050 Roadmap Everything Else Hangs On: Decision 876/QD-TTg Explained
Every recent Vietnamese transport rule, from the Hanoi low emission dates to the national charger standard, traces back to one document. Decision 876/QD-TTg, signed by the Prime Minister on 22 July 2022, approves the Action Programme on green energy transition and the reduction of carbon and methane emissions in transport. It is the parent roadmap of the sector: a phase plan to 2030, a production deadline in 2040, and a finish line, a fully electric and green energy transport system, in 2050.
Document facts
Issuing body: Prime Minister of Vietnam
Document number: Decision 876/QD-TTg, approving the Action Programme on green energy transition, carbon and methane emission reduction in the transport sector
Signed: 22 July 2022
Effective: 22 July 2022
Status: In force; programme horizon 2050
Unofficial English summary for reference only. Not a legal translation and not legal advice. The Vietnamese text linked at the end of this page is authoritative.
What the document does
The programme sets one general objective: develop a green transport system aimed at net zero greenhouse gas emissions by 2050, delivering Vietnam's nationally determined contribution and its methane reduction commitments on the way. It works in two phases. To 2030, the task is to raise energy efficiency and push conversion to electricity and green energy in the parts of transport that are ready in technology, institutions and resources. To 2050, the task is to convert vehicles, equipment and infrastructure across the whole system.
For road transport, the 2022 to 2030 phase promotes the production, assembly, import and conversion to electric road vehicles, expands blending so that road vehicles use E5 petrol universally, develops charging infrastructure to serve households and businesses, and encourages new and existing bus stations and rest stops to convert to green criteria. For rail, it pilots electric and green energy trains on existing lines and plans new lines around electrification.
What changes in practice
The second phase carries the two hardest dates in Vietnamese mobility. By 2040, the programme provides for gradually limiting and then stopping the production, assembly and import of cars, motorbikes and motorcycles using fossil fuel for domestic use. By 2050, 100 percent of road motor vehicles and construction machinery in traffic are to run on electricity or green energy, every bus station and rest stop is to meet green criteria, and charging and green energy supply infrastructure is to be complete nationwide.

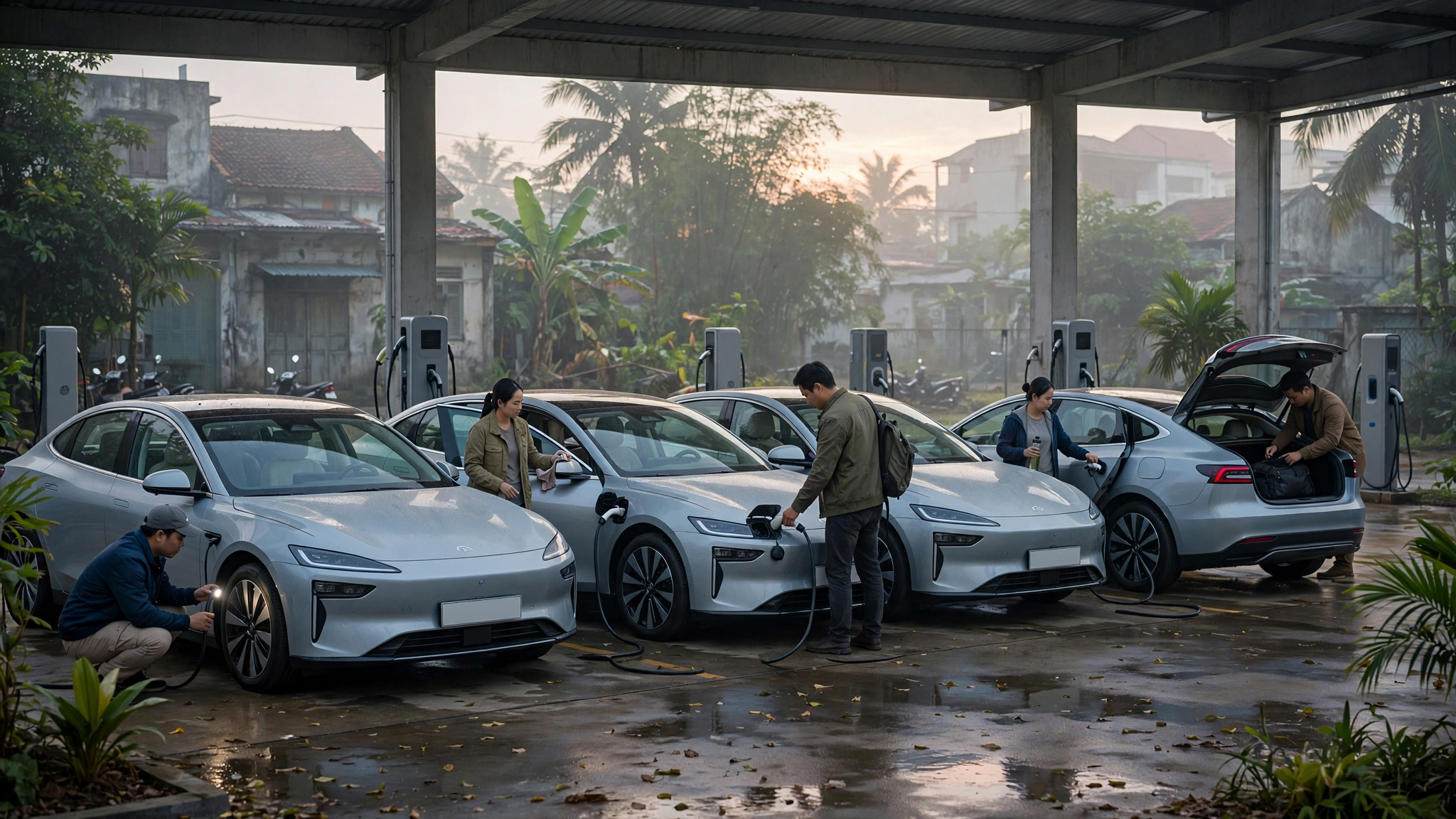

Five years in, the conversion is visibly uneven, which is what a phased programme predicts. Reporting by the Ministry of Construction puts taxis at the front, with more than 61,000 electric taxis out of a national fleet of roughly 86,000, about 70 percent. Buses follow, converting fastest in Ho Chi Minh City at about 60 percent, with Hanoi at about 40 percent and the national rate at about 23 percent. Private adoption is larger in absolute terms: more than 300,000 electric cars are on the road, and registered electric motorbikes number between 3.5 and 4.1 million.
The programme is also the reference point that newer instruments implement. The fee exemption in Decree 202/2026, the charger standard in QCVN 32:2026 and the Hanoi dates in Directive 20/CT-TTg are all, in effect, this programme being converted from goals into enforceable rules, desk by desk and city by city.
Who is affected
In the long run, everyone in the value chain: vehicle manufacturers and importers facing the 2040 production and import horizon; fuel retailers whose core product has a dated future in transport; fleet operators in taxis, buses, logistics and construction; infrastructure investors in charging and energy supply; and the ministries and provinces assigned tasks under the programme. In the short run, the most affected are urban fleets and the suppliers who electrify them, because that is where conversion is being measured first.
Notes for investors and operators
Read Decision 876 as a timetable, not a slogan. The 2040 stop on fossil vehicle production, assembly and import for the domestic market is the single most consequential date for manufacturing strategy in Vietnam, and it was published in 2022, which means long dated capital decisions taken today already sit inside its shadow.
The sequencing matters as much as the dates. The programme electrifies what is ready first, fleets, cities and new infrastructure, and lets the hardest segments convert later; the implementation record so far matches that logic. Investors should therefore weight near term opportunities toward urban fleets, charging and public transport supply chains, and treat the programme's later dates as planning anchors for asset life and residual value, especially for any asset whose business case depends on selling or operating fossil vehicles in Vietnam after 2040.
Sources and the official text
Official full text: Decision 876/QD-TTg and the green transport programme (Industry and Trade Newspaper, Ministry of Industry and Trade, Vietnamese)
Thu Vien Phap Luat, the road transport roadmap and targets of Decision 876/QD-TTg, including the 2040 and 2050 milestones.
Ministry of Construction progress reporting on the programme's implementation, October 2026, for fleet conversion figures.
About this explainer: this page is an unofficial English summary prepared by VoltViet from the official Vietnamese text, for reference only. It is not a legal translation and does not constitute legal advice. Only the Vietnamese original is authoritative. For decisions with legal or financial consequences, consult the official text and a qualified Vietnamese lawyer.
